RAJUK Building Plan Approval in Dhaka: Documents, Drawings and Process

Written and reviewed by Architect Kazi Mohammad Alam Kaiser, Institute of Architects Bangladesh (IAB) member K-172 · Studio Archifiction · Last reviewed 6 November 2026

If you are planning a new building in Dhaka, or revising an approved plan, RAJUK building plan approval starts with your plot and your papers, not with a polished facade. This page explains the approval routes, the documents an owner actually needs, how RAJUK approval drawings are coordinated, and who is responsible for what. Studio Archifiction is an architect-led firm in Dhaka. We review land records, test planning feasibility, prepare and coordinate RAJUK-ready drawings, and support ECPS submission within an agreed written scope. RAJUK makes the decision. No architect or consultant can guarantee approval.

The short answer. A RAJUK plan approval application generally needs four aligned sets of evidence: ownership and identity documents, verified plot and survey information, a proposal checked against current planning and building rules, and coordinated drawings with professional details plus any reports or NOCs the selected route requests. The exact list changes with the land authority, use, scale, location, revision status and project category, so always confirm it against the live checklist inside the ECPS portal.

Modern residential building design in Dhaka prepared for RAJUK plan approval, by Studio Archifiction
A residential building design in Dhaka. The approval journey starts long before this stage: with land records, a verified survey and the right ECPS route.

The first useful question is not “how many floors can I get?” It is “what do the land records, the verified survey, the road and access, the current planning status, the proposed use and the applicable rules allow us to test?” Answering that early protects you from paying for a design that later needs major revision.

Preparing your papers for RAJUK?

Ask for our plot document and RAJUK checklist on WhatsApp. It lists the land papers, survey details and approvals to collect before the drawings start.

Which RAJUK approval route do you need?

RAJUK and ECPS use several related stages. The labels and their required evidence are not interchangeable, so confirm the current route before anyone prepares a final drawing package.

On a phone, swipe the table sideways to see every column.

Stage What it is for What you prepare
Planning Permit (PP)
Some legacy ECPS pages still say Land Use Clearance (LUC)
Confirms the planning and land-use route before construction permission, where applicable Ownership and identity papers, digital survey with plot coordinates, mutation or khatian, land-tax evidence, layout or allotment information, and conditional NOCs as the live form requests. See the current PP/LUC checklist
Construction Permit (CP) The permission needed before construction begins The applicable planning approval, land and support documents, and architectural, structural, electrical and plumbing drawings according to the current CP checklist
Large and Special Project (LSP) Additional review where the current rules or portal classify a project as large or special FAR and floor-area information plus applicable traffic, utility, drainage, environment, geological, flood, waste and authority material. See the current LSP checklist
Construction Start Notice The notice and technical-person certification step at construction stage The approved permit and drawings, appointed professionals, and the current ECPS notice information
Occupancy Certificate (OC) The stage after completion, before the building is used Completion report, as-built architectural and structural drawings, and building-services designs per the current OC checklist

Route check. Check the live ECPS route for your own plot. The current portal and the applicable rules control the requirement. An undated blog post or an old FAQ does not, including this page if RAJUK changes the process tomorrow.

RAJUK approval for an apartment building (G+6 or G+7)

Short answer: an apartment building on your own plot in Dhaka normally moves through RAJUK’s ECPS portal in two stages: Land Use Clearance (the planning permit stage) first, then the Construction Permit. In our experience, plan about 1 to 2 months for the first and about 3 to 6 months for the second, queries included (checked November 2026).

  • Who this is for: a landowner or family building flats on their own plot, for example parking plus six or seven floors.
  • What decides the floors: the plot’s FAR, road width, ground coverage and setbacks, not the G+6 or G+7 label. Our RAJUK DAP and FAR guide works through a 4 katha Bashundhara example.
  • Government fee: BDT 50 per square metre of total floor area for residential use, for the construction permit. For that 4 katha example, about 1,124 sqm, it comes to about BDT 56,200 before VAT.
  • Drawings: the architectural set goes in first; structural, electrical and plumbing drawings follow within the time the rules allow. See the submission checklist.
  • After construction: the occupancy certificate is a separate application.

The steps are in the process section. Rule numbers and official sources are in the time and cost table.

The rules behind the process in 2026

Five instruments sit behind approval right now. They are related, not interchangeable:

  • Dhaka Metropolitan Building Rules 2025. The current metropolitan building-control framework. It structures the Planning Permit, Construction Permit and Occupancy Certificate stages. For years Dhaka ran on the older Imarat Nirman Bidhimala 2008 (ইমারত নির্মাণ বিধিমালা ২০০৮), and most of the FAR, setback and floor-count assumptions owners still hear come from that retired rulebook. Recheck every old assumption against the 2025 rules before you commit money to a design. If the project is a family house, our house design guide shows what to settle before anyone draws.
  • DAP 2022-2035 with its later amendments. The area plan that interacts with your plot and proposal. Since 14 December 2025 it is read together with the Dhaka Metropolitan Building Rules, which changed how a plot’s FAR is taken from the DAP block and the road width. Nobody should promise you FAR, height or a floor count from plot size alone. Our RAJUK DAP and FAR guide works through a FAR calculation and shows why. It also hosts the 2025 and 2008 gazettes for download.
  • BNBC 2020. The technical building code for structure, fire and life safety, and services. “BNBC compliant” only means something when a relevant professional has actually reviewed the design. For an existing building that showed new cracks after the November 2025 earthquake, our Bangla guide on reading wall cracks after the Dhaka earthquake explains which cracks need an engineer.
  • RAJUK Act 2026 and the Bangladesh Building Regulatory Authority Act 2026. The current institutional statutes. They are context for how the authority works, not a substitute for the application checklist.

Where official pages disagree with each other, and right now some legacy ECPS material does conflict, the honest approach is to name the conflict and route the decision to the live application and a qualified review. We follow that approach on this page instead of pretending one blog sentence is law. Current notices sit on the official RAJUK website.

The RAJUK building plan approval process, step by step

1. Confirm jurisdiction, land authority and application route

Start with the plot, not the elevation. Confirm the land is within RAJUK jurisdiction, identify the land or housing authority, check the proposed use and any revision status, and select the correct ECPS application. This is where the Dhaka Metropolitan Building Rules 2025, the amended DAP and BNBC 2020 get read against your actual project.

2. Check whether the ownership story is consistent

The deed or lease, mutation or khatian, tax record, survey, plot area, dag and mouza information, owner identity and any power of attorney should tell one consistent story. Legitimate differences do happen, through inheritance, joint ownership, a lease or an authorised attorney, but each difference needs its supporting correction, title-chain or authorisation document. A drawing cannot repair a record gap. Ownership questions go to a qualified legal professional before detailed design, not after.

3. Verify the site, boundaries, road and access

Use a reliable survey. Plot edges, levels, adjoining roads and their verified widths, access, existing structures and relevant nearby features all affect the design envelope. Road and access information can influence buildable scale, parking, circulation, fire response and external clearances.

4. Test planning feasibility before freezing the plan

The architect should test land use and occupancy, FAR, ground coverage, setbacks, height and category controls, parking, stairs, lifts, means of egress, fire and life safety, light, ventilation, drainage and services as applicable. Plot size alone does not establish an allowable floor count, whatever a neighbour or a broker has promised.

5. Coordinate the RAJUK approval drawings

RAJUK drawing approval in Dhaka is not one attractive floor plan. The live Construction Permit checklist refers to architectural, structural, electrical and plumbing plans or drawings according to the rules. Columns, stairs, parking, shafts, equipment, drainage, area statements and service routes should tell one consistent story across the whole submission.

6. Add only the reports and NOCs your project triggers

External requirements depend on location, use, scale, access, fire risk, aviation constraints, environment and infrastructure. Possible authorities include fire, environment, civil aviation, transport, housing or highway and utility bodies. The objective is not to collect every NOC in Dhaka. It is to identify your actual triggers early, at feasibility stage, before the design is fixed.

7. Submit one consistent dataset and respond to queries

The plot area, use, floor count, total floor area, road information, professional details and drawings entered in ECPS should match each other. The current portal says application payment is online. Save the submission record, and answer authority queries with coordinated revisions rather than changing one sheet in isolation. After the permit, follow the current Construction Start Notice step and build to the approved drawings before the Occupancy Certificate stage.

RAJUK documentation requirements: the owner checklist

Use this as a preparation checklist, not as a universal legal list. The selected ECPS application and its current official checklist decide what must actually be uploaded for your plot.

One thing decides your paper list before anything else: which authority controls the land. A private plot inside RAJUK jurisdiction, a plot in a RAJUK or National Housing Authority project, a housing-society plot, land under a cantonment board, a plot inside a pourashava area and rural land under a Union Parishad do not carry the same requirements. A postal address that says Army or pourashava does not by itself decide the approving authority, so confirm the controlling authority before anything else. It changes the documents, the route, and even which FAR and setback rules apply.

  • Plot inside RAJUK jurisdiction. The 2025 RAJUK route through ECPS applies: current title, survey, tax and identity records, the permission-stage documents, coordinated drawings and any triggered NOCs.
  • Dhaka Cantonment Board or DOHS controlled area. A different regime entirely. The Board’s own route and the current cantonment building by-laws control the forms, fees, signed drawings and clearances, not RAJUK’s checklist.
  • Army or authority land inside RAJUK jurisdiction. RAJUK processing may still apply, plus the allotment or lease record and the controlling authority’s construction permission or NOC.
  • Pourashava area outside a development authority. The municipality’s own committee, current form and local requirements apply. There is no universal pourashava checklist, whatever any blog claims.
  • Union Parishad area, rural land outside any municipality. Approval sits with the Union Parishad for that location under local government rules, not with a development authority and not through ECPS. The owner still has to produce a coordinated drawing set. What changes is who receives it, how the fee is assessed and how long the review takes. Our Salanga community market in Sirajganj is an example of building outside the RAJUK area, and its first phase was completed in 2025.

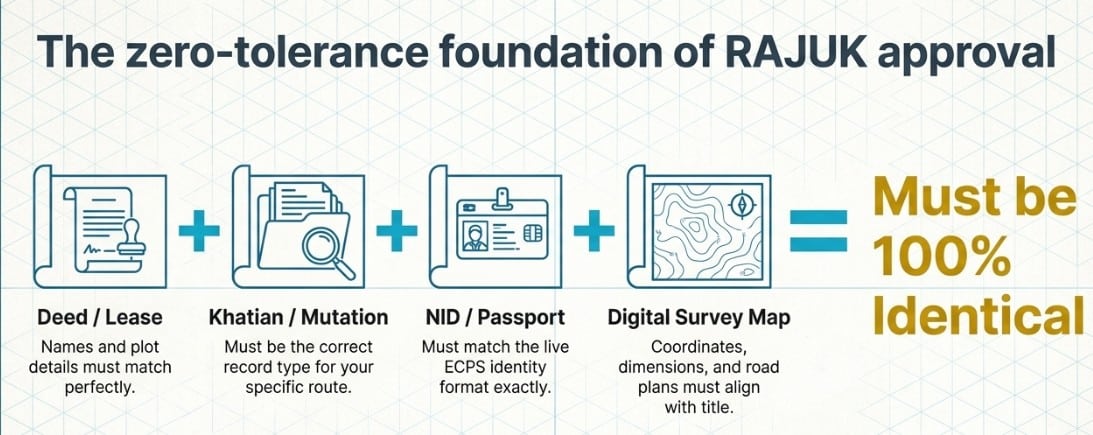

Core RAJUK approval documents: deed or lease, khatian or mutation record, NID or passport, and digital survey map
The target: owner names and identifiers, dag, khatian, mouza, plot area, coordinates and authority records should be consistent, or supported by the correct title-chain, correction or authorisation documents.

Core documents, normally collected

  • Ownership deed, lease or allotment document. Names, plot details, area and authority must be consistent across everything you submit.
  • Khatian or mutation record. Use the record type relevant to your land and route, with the mutation order and DCR where applicable.
  • Current land-development tax or land-tax evidence. Confirm it is up to date before you apply.
  • NID or passport and owner photo. In the identity format the live form requests.
  • Digital survey map with plot-corner coordinates. Coordinates, dimensions, area, road and site plan must agree with each other.
  • RS, MS or City Survey map, mouza or site map. Follow the record type and the selected ECPS route.

Conditional documents, triggered by title, jurisdiction or project

  • Power of attorney. Needed when an authorised person applies or acts for the owner.
  • Title-chain, succession or court documents. Previous deeds, partition, probate, succession or correction evidence, where the ownership history needs support.
  • Approved layout or allotment information. Relevant when the plot sits inside an approved housing or project layout.
  • Current PP, LUC or LSP decision or record. Use the current route for your application, not a blanket answer from any article.
  • Indemnity bond and income-tax return slip. Listed on the current CP checklist. Verify the current format for your application.
  • Easement, clearance or NOC. Only where ownership, access, location or another authority triggers it.
  • Plot-joining map. Only for joined plots, where applicable.
  • Prior approved drawing and permit. For revisions. The original approval record anchors a revised application.
  • Developer enlistment certificate. Where a developer company is part of the application.
  • Previous notice, rejection, query or case record. Share it before design starts so the team understands the history. Hiding it only delays you later.

And a third layer sits above both lists: whatever the live ECPS application workspace or the reviewing authority requests for your specific case. The final upload set depends on the selected application, the approving authority, land tenure and project classification, so treat these lists as preparation and the live workspace as the final word.

RAJUK approval drawings: the submission checklist

The exact sheet list depends on the route and the project. This is the coordination checklist we run before uploading RAJUK approval drawings, with the responsible professional for each part.

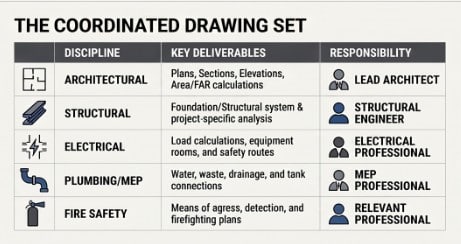

Coordinated RAJUK drawing set for building approval in Dhaka: architectural, structural, electrical, plumbing and fire safety drawings as one set
One submission, five disciplines. Each discipline has an owner, and the lead architect keeps every sheet telling the same story.
  • Site and location plan, by the architect and surveyor. Boundaries, coordinates, adjoining roads, access, nearby structures, north point and scale.
  • Architectural floor plans, by the architect. Use, dimensions, circulation, stairs and lifts, parking, shafts, rooms, openings and accessibility where applicable.
  • Sections, elevations and roof plan, by the architect. Levels, heights, setbacks and open space, facade openings, roof and services, and the relevant annotations.
  • Area and rule calculations, by the architect. Plot area, FAR, ground coverage, setbacks, height, floor areas, occupancy and use, parking and egress as applicable.
  • Structural drawings and calculations, by the structural engineer. Foundation and structural system with project-specific analysis, coordinated with the architecture.
  • Electrical drawings, by the electrical professional. Loads, routes, rooms and equipment, and safety coordination as required.
  • Plumbing, sanitary and drainage drawings, by the plumbing or MEP professional. Water, waste, drainage, shafts, tanks and connections, coordinated with the rest of the set.
  • Fire and life-safety material, by the relevant professionals. Means of egress, detection and alarm, firefighting and equipment where the route requires it.
  • Professional details and signatures. Names, roles, registration data and digital signatures must match the portal records.
  • Sheet coordination and revision control, by the lead architect. Same grid, dimensions, cores and column positions, areas, use, title, revision and date across every file.
  • File and upload quality. Readable scale, orientation, filenames, scan quality, version and the requested format and size.

About the soil test. A soil investigation may be essential for safe structural design, depending on the ground and the project. Confirm the engineering need, and separately confirm whether your selected application requires an uploaded report. It is an engineering input first, not a universal portal attachment.

Conditional reports and NOCs

Large, special or location-sensitive projects can require additional material. Screening should happen at feasibility stage, before the design is fixed. Common triggers and the bodies involved:

Conditional reports and NOCs: common triggers
Trigger Body involved What it can change
Fire and life-safety category FSCD Stairs, exits, refuge, detection, equipment and access
Aviation, height or location CAAB or another location clearance Permissible height and design assumptions
Environment or sensitive use DoE (clearance and environmental report) Siting, services and mitigation
Traffic or major access impact DTCA or a traffic study Access, circulation, parking and the road interface
Government housing or highway adjacency NHA, RHD or the relevant authority External confirmation of land or access jurisdiction
Large or special site conditions Utility, drainage, geological, flood, waste and planning reports The scheme itself and the submission route

What usually causes a query, correction or delay?

Most delays we see are preventable, and almost all of them are created before submission, not after it:

What causes a query, correction or delay, and how to prevent it
Cause What goes wrong Prevention
Record mismatch Owner name, plot area, dag, mutation, map or survey disagree Resolve it before detailed design, with legal advice where needed
Unverified road or access The design relies on a claimed width the record does not support Verify before calculating the envelope
Wrong application route Planning, revision or LSP requirements found after the drawing set is complete Screen the route first in ECPS
Area inconsistency Totals, FAR table, floor plans and schedules use different numbers Keep one checked area schedule and update everything together
Discipline conflict Columns block parking, shafts move, stairs or services disagree Run a coordinated architecture, structure and MEP review before upload
Late NOC or report A location or use trigger appears after concept approval Build a trigger register at feasibility stage
Poor version control Old sheets or unreadable scans get uploaded Use a submission register, clear filenames and a final upload check
Overpromised scheme A floor count was promised before survey and rule checks Treat early targets as targets, not entitlements
Aerial view of a residential building design with rooftop garden in Dhaka, prepared for RAJUK plan approval
An aerial study of a residential building design in Dhaka. Massing, setbacks and the roof are approval decisions, not only design decisions.

How long does RAJUK approval take, and what does it cost? The official figures for 2026

Two clocks run on every application. The first is yours: land records, survey, feasibility, design decisions and the coordinated drawing set. The second is the authority’s review, and the Dhaka Metropolitan Building Rules 2025 (gazetted 14 December 2025) put time limits on it. The same rules fix the government fees in their Appendix 4, which you can check in RAJUK’s official copy of the 2025 gazette (gazette pages 13516 and 13517). The table gives those figures with the rule they come from, plus what the stages have taken on our own files when the papers were clean.

RAJUK approval stages: official fee, statutory time, and what we see in practice (2026)
Stage Government fee (Appendix 4, 2025 rules) Time limit in the rules In practice, clean file
Planning approval letter (ECPS “Planning Permit”, the old Land Use Clearance) BDT 5,000 per application; the same for an appeal or a validity extension (Appendix 4, item ক) Decision within 30 working days of application; 45 working days for sites above 5 acres, block developments and special buildings (Rule 6(1)). Valid 24 months (ECPS FAQ). About 1 to 2 months
Construction approval (ECPS “Construction Permit”) Per square metre of total floor area, all floors together: BDT 50 for residential A-1, A-2, A-3 and A-6; BDT 75 for A-4 and A-5 (hostels, mess, hotels); BDT 150 for business and mercantile uses (Appendix 4, item গ). For the 4 katha residential example in our FAR guide, about 12,100 sft or 1,124 sqm, that is about BDT 56,200 before VAT, for the construction permit only. An incomplete file is notified within 30 days; you then have 30 days to complete it, at most twice (Rule 13(1), 13(2)). The building construction committee recommends approval or rejection within 45 days of receiving the complete drawings (Rule 13(8)). If the architectural drawing goes in first, its approvability is confirmed within 30 days and the structural, electrical and plumbing drawings follow within 180 days (Rule 13(4) to 13(6)). About 3 to 6 months from submission to permit, queries included
Occupancy certificate, and its renewal BDT 1,000 per application (Appendix 4, item ঝ) Applied for after completion, with the as-built technical documents Depends on the completion inspection
Other charges Boundary wall approval BDT 20 per sqm, minimum BDT 2,000 (Appendix 4, item ঙ); any appeal BDT 5,000 (Appendix 4, item ট). The ECPS FAQ adds 15 percent VAT to application fees. Third-party costs (digital survey, soil test, NOCs) and professional fees are separate; our fee note is in the questions below.

Two cautions. The ECPS FAQ page still shows the older BDT 1,000 Land Use Clearance fee and the 15 working days of the 2008 rules; the 2025 gazette supersedes both, and the live amount is calculated inside your ECPS application, so pay what the portal shows and keep the receipt. And the statutory clock only runs on a complete file: a query, a revision or an external clearance restarts the count, which is why the practice column is longer than the rules column.

How to check RAJUK plan approval status online

RAJUK applications now run through ECPS, the Electronic Construction Permitting System at ecps.gov.bd. So the online check happens inside the applicant’s own ECPS account, not on a public page.

  1. Log in to the ECPS account used for the application. This is the owner’s or applicant’s account, created at registration.
  2. Open the application from your dashboard. The record shows the current stage, any query from the reviewing department and any notice issued to you.
  3. Answer queries inside the same record. Upload coordinated revisions there, so the file stays complete and traceable.
  4. Keep the application number and every payment receipt. You need them for any follow-up at the RAJUK zone office.

If a consultant files for you, ask for the application number and a screenshot of the status page after every change. You should never have to guess where your file stands.

Is there a RAJUK approved plan list you can search?

Not for individual buildings, as far as we could find in October 2026. Neither ECPS nor the RAJUK website offers a public search that confirms whether a particular building’s plan is approved. The RAJUK website does publish some updated lists, including approved layouts of private residential housing projects, which help when the plot sits inside a housing project.

For a single building, or a flat you plan to buy, verify it this way:

  • Ask the owner or developer for the approval letter and the approved drawing set, with the application or permit number.
  • Match the details: plot number, plot area, use, floor count and building outline should agree with what stands on site.
  • Count the floors. More floors on site than in the approved set is a warning sign, whatever the brochure says.
  • If anything looks inconsistent, confirm with the RAJUK zone office that covers the plot.

Approval status can affect bank loans and resale, so do this check before you pay anything.

Who is responsible for what?

Approval goes more smoothly when everyone knows their lane. This is how the responsibility actually divides:

On a phone, swipe the table sideways to see every column.

Party Handles Does not control
Owner or applicant Authentic records, identity, decisions, access, payments and full project history Technical compliance or RAJUK’s decision
Lead architect Feasibility, architectural design, drawing coordination, submission support and query responses within the agreed scope Land-title validity, third-party response time, or any approval guarantee
Structural, MEP and fire professionals Their technical inputs and the coordination of those inputs Other disciplines or authority decisions outside their role
Surveyor, legal adviser, specialists Accurate survey, legal, traffic, environmental or geotechnical evidence The complete multidisciplinary outcome, unless appointed for it
External authorities Project-specific NOCs and clearances where required RAJUK’s final decision
RAJUK Reviewing and deciding the application under its current process The owner’s records, consultant quality, or project execution

What Studio Archifiction can help with

Studio Archifiction provides an architect-led building design service in Dhaka and architectural consultancy. Depending on the written appointment, the scope can include initial document review, site and feasibility review, architectural design, RAJUK-ready drawing preparation, coordination with structural and MEP professionals, submission documentation support, responses to drawing-related queries, detailed drawings and site-stage review. If you are looking for an architect for RAJUK plan approval support, this is the shape of the work we actually do.

Full-service RAJUK approval in Dhaka. If you are looking for a RAJUK approval consultant in Dhaka who handles the whole file, we take it from document review to RAJUK’s decision: feasibility against the current rules, the RAJUK-ready drawing set with structural, electrical and plumbing drawings coordinated, ECPS submission by our team, answers to queries and follow-up until RAJUK decides. You supply authentic records and decisions. We manage the rest.

The fee is quoted per project after a first review, because it depends on plot size and floor count, the use (residential, commercial or mixed), the application route (new permit, revision or large and special project), the condition of the land papers, the reports and NOCs your project triggers, and whether full building design is part of the appointment. Design-only and drawing-only appointments are also available if you already have a team for the rest.

Our building design work is led day to day by Alamgir M Mahmud, our Lead Architect for building design and Institute of Architects Bangladesh member M 063, with design direction from Principal Architect Kazi Mohammad Alam Kaiser, IAB member K-172. Any proposal we send identifies which consultants are included, which documents the owner must supply, which reports and NOCs are separate, how many design revisions are included, who files and follows up in ECPS, and what happens after a query. Studio Archifiction is not RAJUK and cannot guarantee an approval date or outcome.

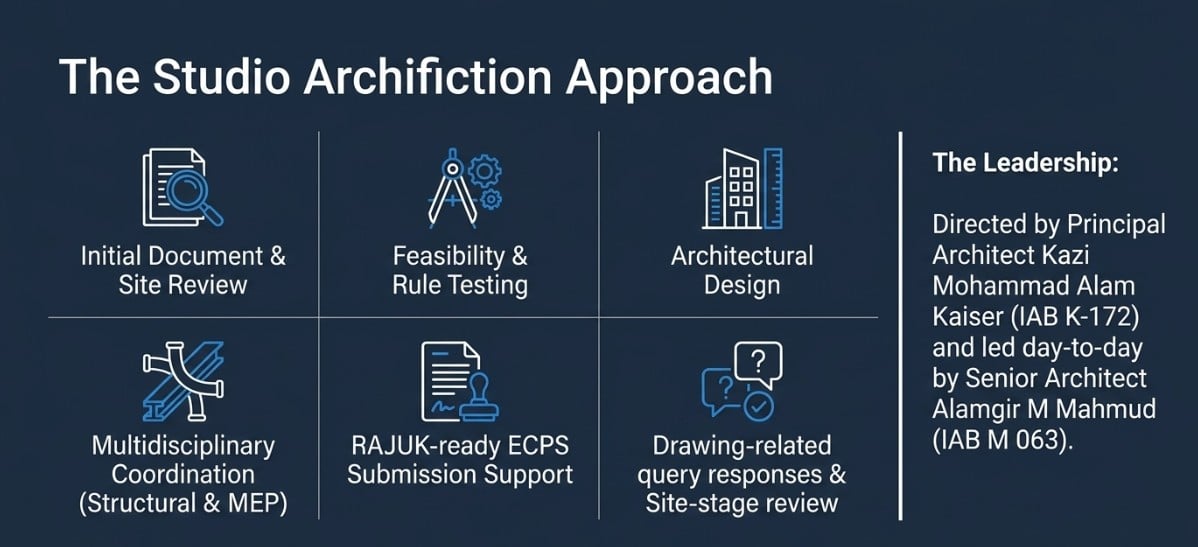

The Studio Archifiction approach to RAJUK plan approval, from document review and feasibility to ECPS submission support and query responses

From first discussion to RAJUK-ready drawings: how the design phase runs

To start, we do not need much: the land location, the plot size or a digital survey if you have one, the front road width, and the building type you have in mind. With that we run the first feasibility pass, testing FAR, setbacks, ground coverage and parking against the current rules. Then we sit with you and talk honestly about what the plot can carry: a realistic floor count, floor sizes, parking numbers and the design elements that matter to your family or your business. Our proposal comes after that conversation, with the scope of work written out clearly, so nothing important is left assumed.

Once the requirements are locked, we develop design options with plans and 3D views, so you compare real alternatives instead of accepting one take-it-or-leave-it scheme. After you finalise a direction, the detailed drawing phase begins, and that is where the RAJUK-ready set takes shape: architectural details coordinated with structural, electrical and plumbing drawings for ECPS submission. If queries or revisions come after submission, we support those too. After approval, the next steps follow the agreed scope. Some clients take us through construction; others keep us for top supervision. We prefer to handle a building from design start to project end, because that is how the drawings, the site and the budget stay in one line.

A real example: Dr. Jasim’s Residence, Bashundhara

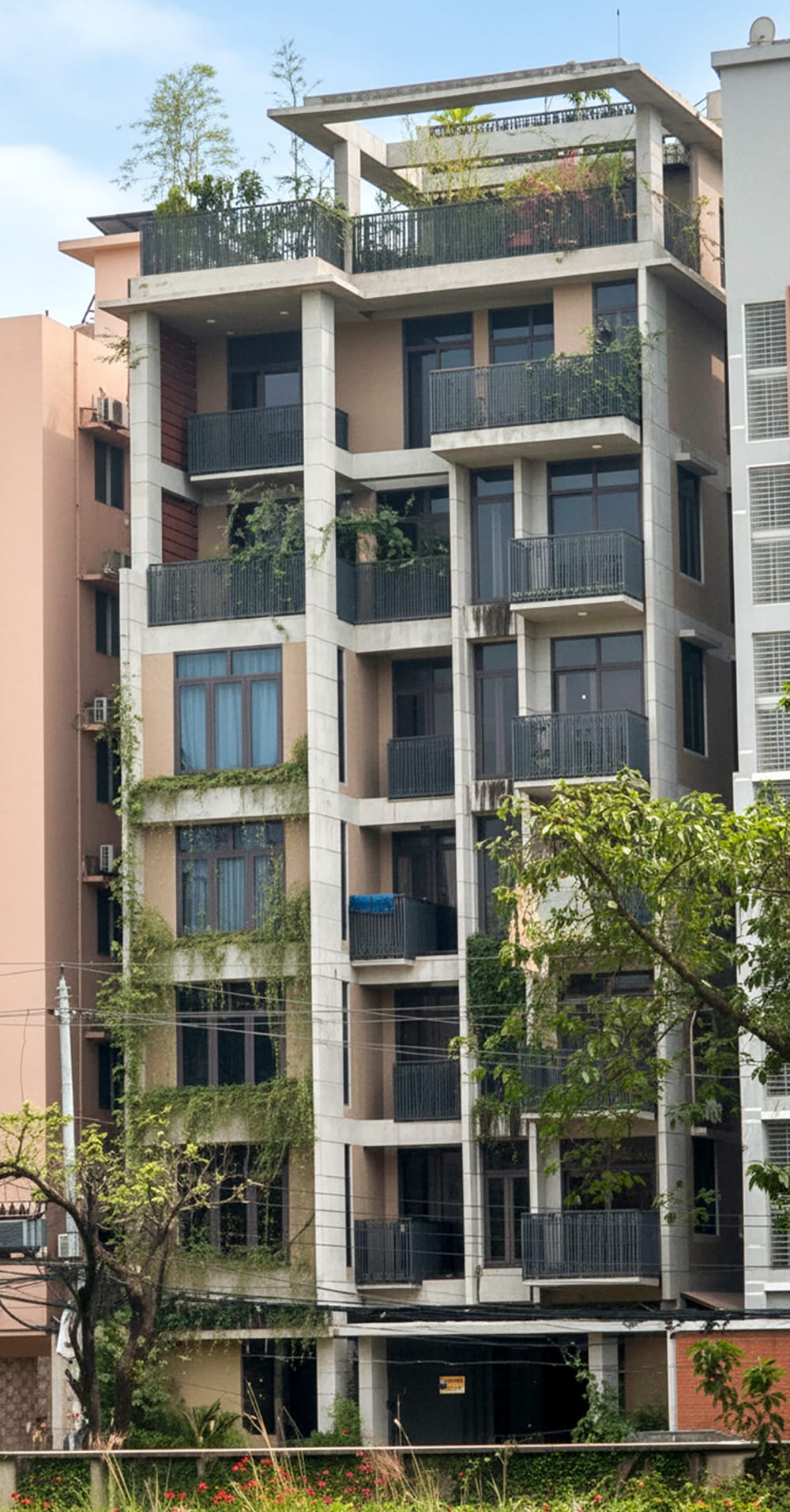

Completed G+6 residential building at Dr. Jasim's Residence, Bashundhara, Dhaka, designed and supervised by Studio Archifiction
The completed building in Bashundhara. Not a render: this is the built result of the same documentation and coordination process described on this page.

On a 4 katha plot we handled feasibility, building design, RAJUK approval documentation, structural and MEP coordination, construction and site supervision for a G+6 residential building. Mid-project the client’s priorities shifted toward rental income and the budget tightened. We protected the planned spaces and adjusted materials instead of cutting usable area, and the building is complete and in use today. The full building design and documentation case study shows how RAJUK-ready drawings are coordinated on a live project. The family duplex on its top two floors, and what a duplex needs on the drawings, is covered in our guide to duplex house design in Bangladesh.

Comparing firms before you appoint one? Our shortlist of top architecture firms in Bangladesh explains what to check first.

What to send for an initial plot-and-document review

The same review applies whether you need RAJUK approval for an apartment building, a duplex house or a commercial plot; only the drawing set and the NOCs change. You do not need a complete file to start. Send what you have from this list:

  • Plot location and a map pin
  • Plot size, edge dimensions and any available survey
  • Deed or lease, mutation or khatian, current land-tax evidence and available maps
  • Land authority, housing project or approved-layout information
  • Verified road and access record, if available
  • What you want to build and the intended occupancy or use
  • Target floors, units, parking and special functions, clearly labelled as targets
  • Any previous approval, revised plan, notice, rejection, query or existing construction
  • The service scope you prefer: feasibility, design, drawings, submission support, coordination or site review

Next step. Send your plot and document details for an initial review, or message us on WhatsApp at +880 1716-501213. Our first response identifies what can be assessed now, what must be verified, and which professional scope fits your project.

Frequently asked questions

What documents are required for RAJUK plan approval?

Common groups include ownership and identity records, mutation or khatian and tax evidence, survey and map information, the applicable planning decision, coordinated drawings, professional details, and conditional NOCs or prior approvals. The live checklist for your selected application controls the final list.

Do I always need a Land Use Clearance before a Construction Permit?

Under the 2025 rules a planning permit, the old Land Use Clearance, normally comes before the construction permit. Some legacy ECPS pages still use the LUC wording, so confirm the plot’s land authority and the route shown in your live ECPS application, then verify it with the responsible professional before submission.

Does RAJUK approve only the architectural drawing?

No. The current Construction Permit checklist refers to architectural, structural, electrical and plumbing plans or drawings according to the applicable rules. Project-specific fire and other technical material may also apply.

Is a soil test always uploaded?

A soil investigation may be required for safe structural design, depending on the ground and the project. Confirm the engineering need and whether your selected application requires the attachment. Do not treat it as a universal portal item.

How many paper copies are required?

Use the live ECPS checklist and the current zone instruction. The present process is electronic. Do not print a fixed quantity based on a legacy FAQ or an old article.

How long does RAJUK approval take?

The 2025 rules set the authority’s clock: a planning approval decision within 30 working days (45 for sites above 5 acres and special buildings), and a building construction committee recommendation within 45 days of a complete drawing set, with 30-day windows for completing an incomplete file. In our recent Dhaka projects a clean file has taken about 1 to 2 months for the planning permit and 3 to 6 months for the construction permit, queries included. Your own preparation (records, survey, coordinated drawings) comes before either clock, so ask for a project-specific programme rather than a guaranteed date.

What does RAJUK approval cost?

Government fees under the 2025 rules, Appendix 4: BDT 5,000 for the planning approval application, BDT 50 per square metre of total floor area for a residential construction permit (BDT 75 for hostels and hotels, BDT 150 for business and mercantile buildings), BDT 1,000 for the occupancy certificate, plus 15 percent VAT per the ECPS FAQ. A 4 katha parking-plus-six residential building of about 12,100 sft works out at about BDT 56,200 before VAT for the construction permit alone (12,100 sft is about 1,124 sqm at BDT 50 per sqm); it is not the total approval budget. Third-party costs (digital survey, soil test, NOCs) and the consultant’s fee are separate; the live amount is calculated inside your ECPS application.

What if I am revising an approved plan?

Share the prior approved drawing and permit before design work starts. The current CP checklist identifies the previously approved drawing as applicable to a revised Construction Permit.

Can a consultant guarantee approval?

No. A consultant can assess feasibility, prepare and coordinate the submission, respond to queries and reduce avoidable errors. RAJUK decides.

Who can handle RAJUK approval documentation for my building?

An architect-led team that can prepare the coordinated drawing set and manage the ECPS file for you. Studio Archifiction offers this as a full service in Dhaka: feasibility, RAJUK-ready drawings with structural and MEP coordination, ECPS submission, query responses and follow-up until RAJUK decides. Our building work is led by IAB members (K-172 and M 063). No consultant can guarantee approval.

How is a consultant’s fee for RAJUK plan approval calculated?

It is quoted per project. Plot size and floor count, use, application route, the condition of the land papers, triggered reports and NOCs, and whether full building design is included all change the work. Ask for a written scope that lists what is included and excluded. Government charges are separate and paid online inside ECPS. For reference, Studio Archifiction’s design consultancy fee is roughly BDT 50 to 100 per sft of the flats’ usable floor area including balconies (the parking floor, stair, lift and lobby are not charged), usually about BDT 4 to 8 lakh in total for a 4 katha parking-plus-six building (November 2026). The full scope, toward BDT 100, covers architectural design with 3D views, the RAJUK-ready drawing set with ECPS submission and query responses, structural and MEP design, working drawings and the BOQ; a smaller scope costs less, and site-stage review is priced by the number of visits. Government and RAJUK fees, printing and other costs are extra, and the fee is fixed in writing once the scope is agreed; the full scope table is on our building design page.

How can I check RAJUK plan approval status online?

Log in to the ECPS account used for the application and open the application record. It shows the current stage, queries and notices. If a consultant filed for you, ask for the application number and a status screenshot after each change.

Is there a public RAJUK approved plan list?

Not for individual buildings, as far as we could find in October 2026. The RAJUK website publishes some lists, including approved private housing project layouts. For a single building, ask for the approval letter and approved drawings and match them with the building on site.

What happens after approval?

Build in accordance with the sanctioned plan and the coordinated technical documents, follow the required construction-stage process including the Construction Start Notice, and prepare for the Occupancy Certificate stage after completion and before use. The current OC checklist includes completion and as-built technical documents.

রাজউক থেকে প্ল্যান পাস করতে কত সময় ও খরচ লাগে? (২০২৬)

সময়প্রায় ৪ থেকে ৮ মাসPlanning permit ও construction permit মিলিয়ে, কাগজ পরিষ্কার থাকলে। প্রস্তুতির সময় এর বাইরে।
সরকারি fee: ৪ কাঠা, parking + ৬ তলাপ্রায় BDT ৭০,৪০০Planning ও construction permit, ১৫% VAT সহ। Consultant fee আলাদা। সূত্র: বিধিমালা ২০২৫

সময়: চার ধাপে

  1. প্রস্তুতিজমির কাগজ, survey, feasibility, coordinated drawing ও report।Plot আর কাগজের অবস্থার উপর নির্ভর করে
  2. Planning permitআইন অনুযায়ী আবেদনের ৩০ কার্যদিবসে সিদ্ধান্ত (বিধি ৬)।আমাদের অভিজ্ঞতায় ১ থেকে ২ মাস
  3. Construction permitসম্পূর্ণ drawing জমার পর ৪৫ দিনের মধ্যে ইমারত নির্মাণ কমিটির সুপারিশ (বিধি ১৩)।আমাদের অভিজ্ঞতায় ৩ থেকে ৬ মাস
  4. Occupancy certificateনির্মাণ শেষ হলে আলাদা আবেদন।Fee BDT ১,০০০ + VAT

সরকারি fee: একটা উদাহরণ

খাত হিসাব টাকা
Planning approval আবেদন নির্দিষ্ট fee পরিশিষ্ট ৪ (ক) BDT ৫,০০০
Construction permit (আবাসিক) মোট মেঝে প্রায় ১২,১০০ sft বা ১,১২৪ বর্গমিটার × BDT ৫০ পরিশিষ্ট ৪ (গ) BDT ৫৬,২০০
VAT ১৫%, ECPS-এর FAQ অনুযায়ী প্রায় BDT ৯,২০০
মোট ৪ কাঠা, parking + ৬ তলা প্রায় BDT ৭০,৪০০
পরে: Occupancy certificate নির্মাণ শেষে পরিশিষ্ট ৪ (ঝ) BDT ১,০০০ + VAT

ECPS portal-এ online payment হয়। চূড়ান্ত টাকা সেখানে live হিসাবেই দেখাবে।

পুরো খরচ তিন ভাগে

সরকারি feeউপরের table-এর মতো, ECPS-এ পরিশোধ।
Survey, test ও NOCThird-party খরচ, plot আর project অনুযায়ী আলাদা।
Consultant feeপ্রতি sft প্রায় BDT ৫০ থেকে ১০০, balcony সহ flat-এর usable floor area-র উপর (parking, সিঁড়ি, লিফট ও লবি বাদে)। ৪ কাঠায় parking + ৬ তলায় সাধারণত প্রায় BDT ৪ থেকে ৮ লাখ।

BDT ১০০-এর কাছাকাছি fee-তে থাকে: 3D সহ architectural design, ECPS submission ও query response সহ RAJUK-ready drawing set, structural ও MEP design, working drawing ও BOQ। Scope কম হলে fee কম। Site visit আলাদাভাবে ধরা হয়, আর সরকারি fee ও printing এর বাইরে।

নির্দিষ্ট তারিখের প্রতিশ্রুতি দেওয়া সম্ভব নয়। পরিষ্কার কাগজের নিয়মিত plot আর জটিল revision বা restricted location এক নয়। তাই কাজ শুরুর আগে project-ভিত্তিক preparation programme চেয়ে নিন।

সূত্র: ঢাকা মহানগর ইমারত বিধিমালা ২০২৫ (বিধি ৬, বিধি ১৩, পরিশিষ্ট ৪) ও ECPS FAQ। বাস্তব সময় ও consultant fee Studio Archifiction-এর অভিজ্ঞতা ও হিসাব, নভেম্বর ২০২৬।

Important. This page is practical architectural guidance, not a legal opinion or an approval guarantee. Requirements change and are project-specific. Confirm the current ECPS route, checklist, rules, DAP material and zone requirements at the time of submission.

Ready to start your building project? Message us on WhatsApp at +880 1716-501213 with your plot location and what you want to build, or send your details through our contact page. We will tell you honestly what can be assessed now, what needs verification, and which scope fits your project. And if you spot a RAJUK or ECPS change this page has not caught yet, send us that on WhatsApp too. We recheck this page whenever the rules, DAP material or ECPS checklists change.

Official sources checked for this page: the ECPS portal and its current permit checklists, the RAJUK official website, the Dhaka Metropolitan Building Rules 2025, the December 2025 building rules gazette, the current DAP amendment and BNBC 2020.
